Exposed Aggregate 4 days on site

Cracked, lifting driveway to exposed-aggregate.

Highton. A cracked, lifting old driveway on a reactive-clay Highton block, replaced with an exposed-aggregate driveway on a compacted base and heavier mesh.

Project
041
Completed
Mar 2026
Build time
4 days
Footprint
60 m², 150 mm slab
A finished exposed-aggregate driveway leading up to a Highton brick home on a sloping reactive-clay block
The same Highton home before, with an old cracked and lifted plain-grey driveway slab
Before After
Cracked, lifting driveway to exposed-aggregate, Highton. A cracked, lifting old driveway on a reactive-clay Highton block, replaced with an exposed-aggregate driveway on a compacted base and heavier mesh.

The job

What we walked into, and what we did.

The problem

A 60 square metre driveway on a sloping Highton block had cracked right across the middle and lifted at the joints within a few summers, because it had been poured thin over loose fill with no control joints. Two earlier quotes were a single round number with no thickness, no mesh and no finish named.

Our approach

We measured the area, set out the falls and priced it by the m², with the thickness, the SL82 mesh and the exposed-aggregate finish on the quote. We broke out and carted away the old slab, dug and compacted a proper base, stepped the thickness up to 150 mm with heavier mesh for the reactive clay, formed up and poured, washed back the stone, sealed it and cut control joints at the right spacing.

The result

A flat, crack-controlled 60 square metre exposed-aggregate driveway that grips in the wet and takes the cars, with the old slab and spoil carted away and the tip fees itemised. Handed over with the safe-to-drive date marked and the 10-year slab and footings guarantee in writing.

Materials

  • Concrete to AS 1379 at 32 MPa, exposed-aggregate finish
  • 150 mm slab on a compacted base with SL82 mesh
  • Penetrating sealer over the washed-back stone

Named in writing

Materials and the honest number.

Finish Exposed aggregate, washed back and sealed Stone matched to the house, named on the quote
Slab 150 mm on a compacted base Stepped up for reactive clay and the grade
Reinforcement SL82 mesh, 32 MPa to AS 1379
Guarantee 10-year slab & footings, in writing
What a job like this costs
$8,400
supplied and laid, 60 m² of exposed aggregate
Exposed-aggregate supply + lay + seal$7,200
Old-slab break-out + tip fees$900
Extra thickness and mesh, reactive clay$300
Price a project like this

4 days on site

How the job ran.

  1. Day 1

    Break out and dig

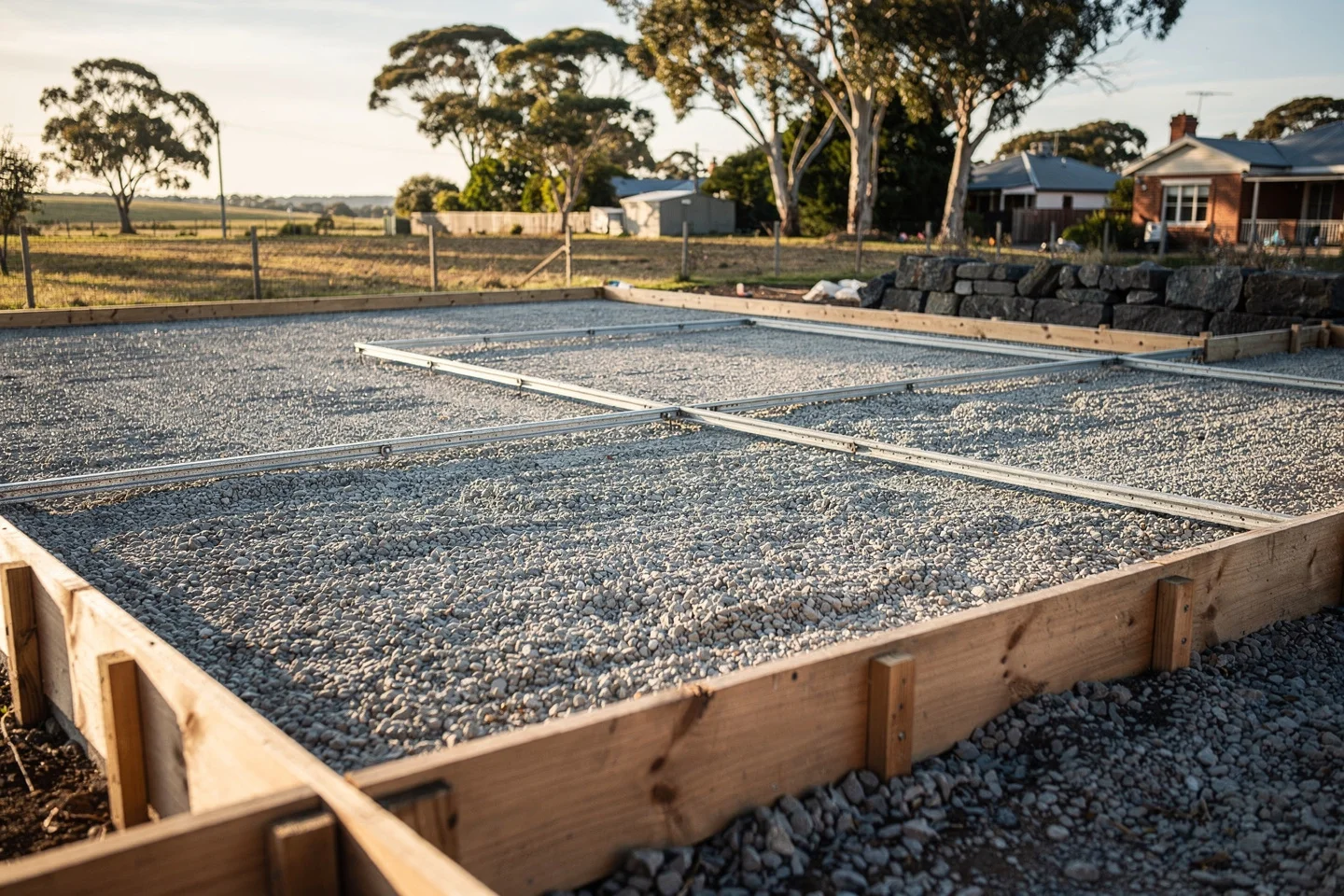

    Old cracked slab broken out and carted away, the base dug and compacted along the falls.

  2. Day 2

    Base, form and reo

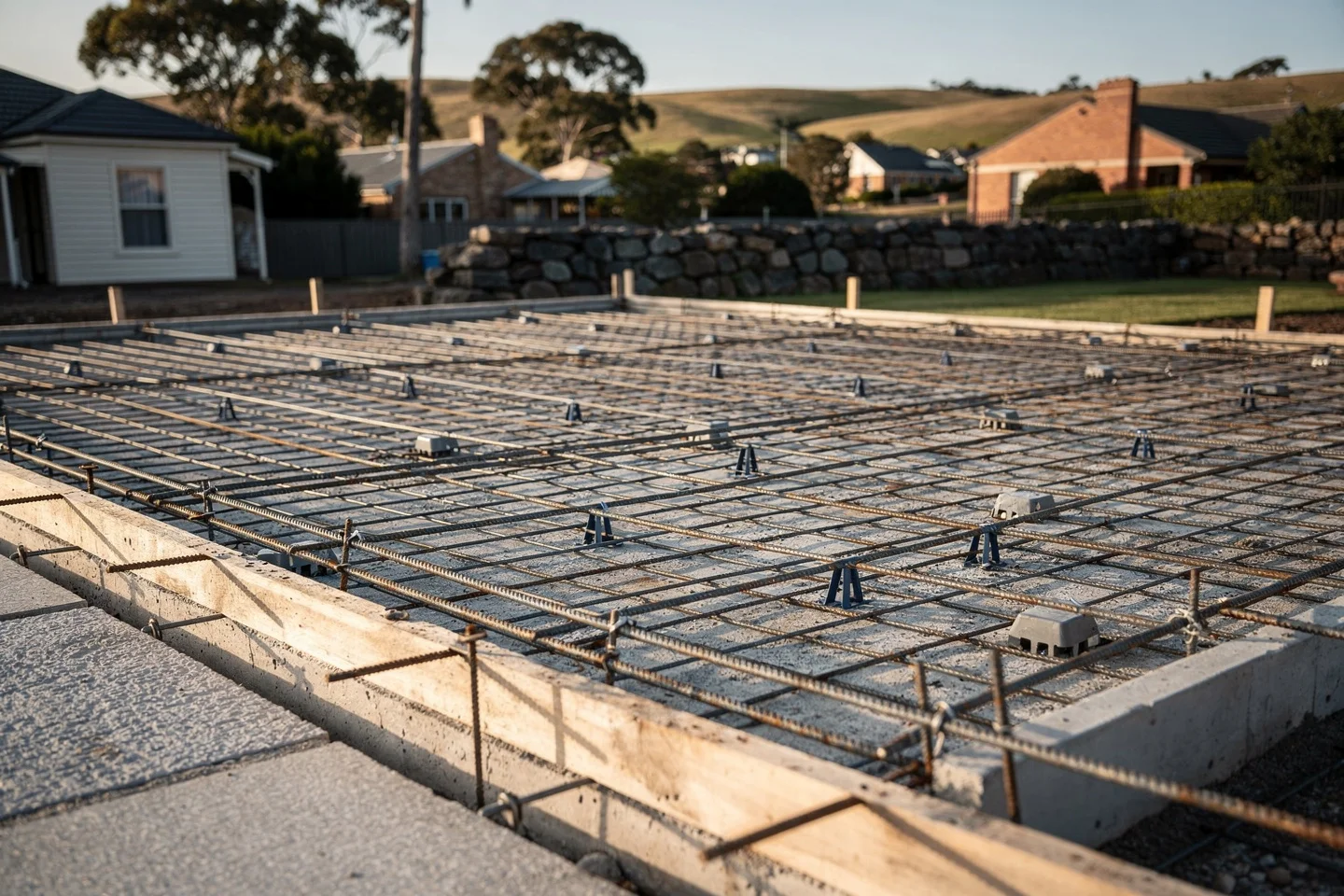

    Compacted base finished, formwork set to the falls and SL82 mesh laid on chairs.

  3. Day 3

    Pour and expose

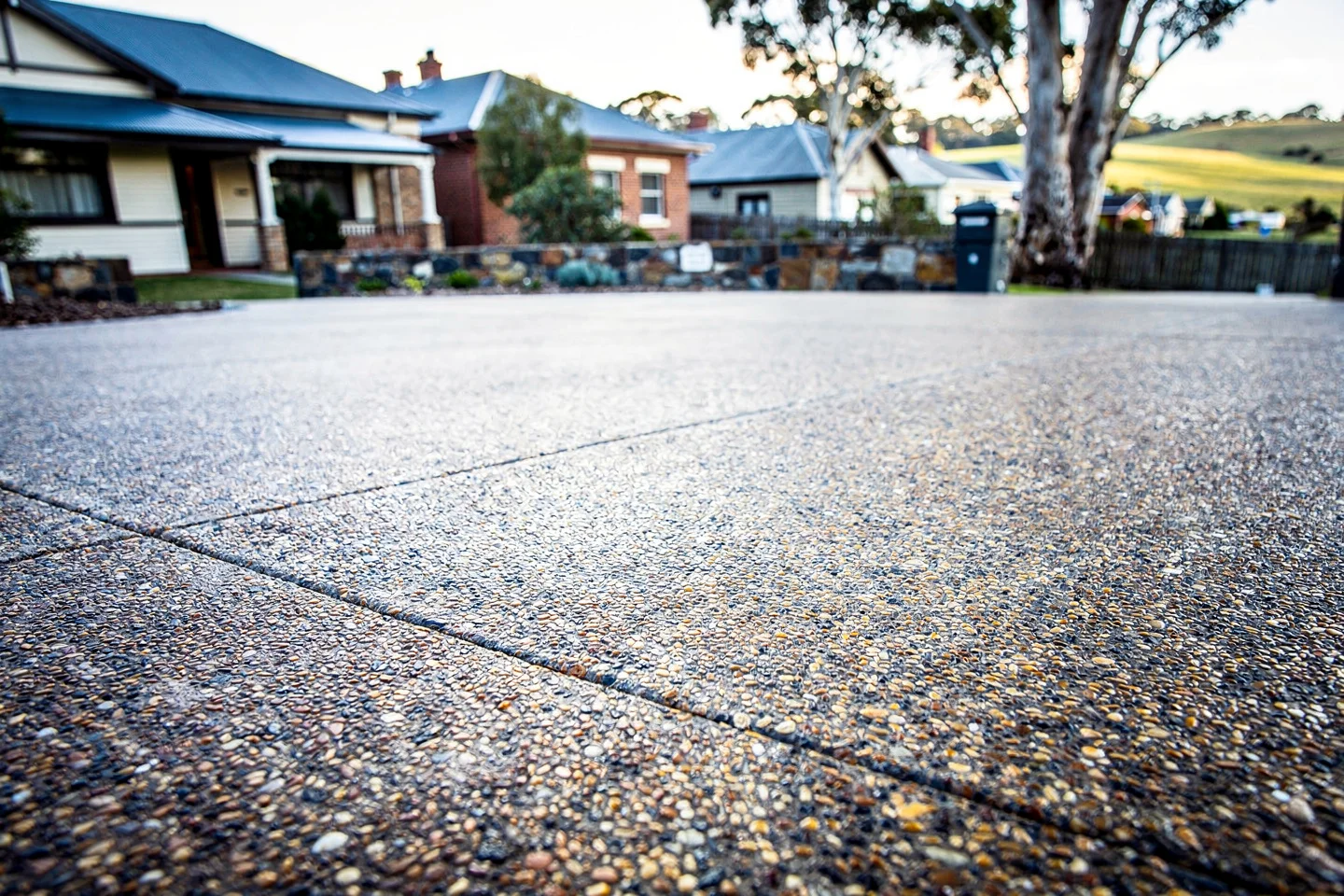

    Concrete placed at 32 MPa, screeded, and the top washed back to expose the stone.

  4. Day 4

    Seal, joint and clean-up

    Surface sealed, control joints cut, site cleared, safe-to-drive date marked and warranty handed over.

On site

A closer look.

“Three quotes, and Slabline was the only one that named the thickness, the mesh and the finish. The driveway is dead flat now and grips in the wet, after the last one cracked across the middle in two summers.”
Sarah M. · Highton
